Project Management (ECPA) Overview

Required licence

ecpa — one code for the whole module, all or nothing. There are no sub-licences, so there is no half-licensed state to explain: either every screen below is in the menu, or none of it is. The menu root reads Project Management (ادارة المشاريع).

An engineering office does not sell anything you can put on a shelf. What it sells is Tuesday afternoon: a structural engineer's four hours over a foundation drawing, a draughtsman's day redlining a floor plan, a partner's hour in a client meeting. The stock is people, the cost is salaries, and the two questions that keep a practice awake are who worked on what and when can we invoice it.

Project Management is Nama's module for exactly that shape of firm — architecture and engineering offices, consultancies, audit and legal practices, design studios. Everything in it assumes the deliverable is professional work, priced by the hour or by an agreed fee per phase, and that the hard part is turning recorded hours into a defensible invoice.

Several pages in this documentation follow one firm:

Al-Manara Engineering wins a design job for customer CUST-011, the Tower Fit-out Design, which becomes project PRJ-0042. The job is billed in four phases — concept, schematic, detailed design, tender documents — and three of Al-Manara's disciplines work on it: architectural, structural and electrical. Sara (EMP-7) is one of the architects assigned to it.

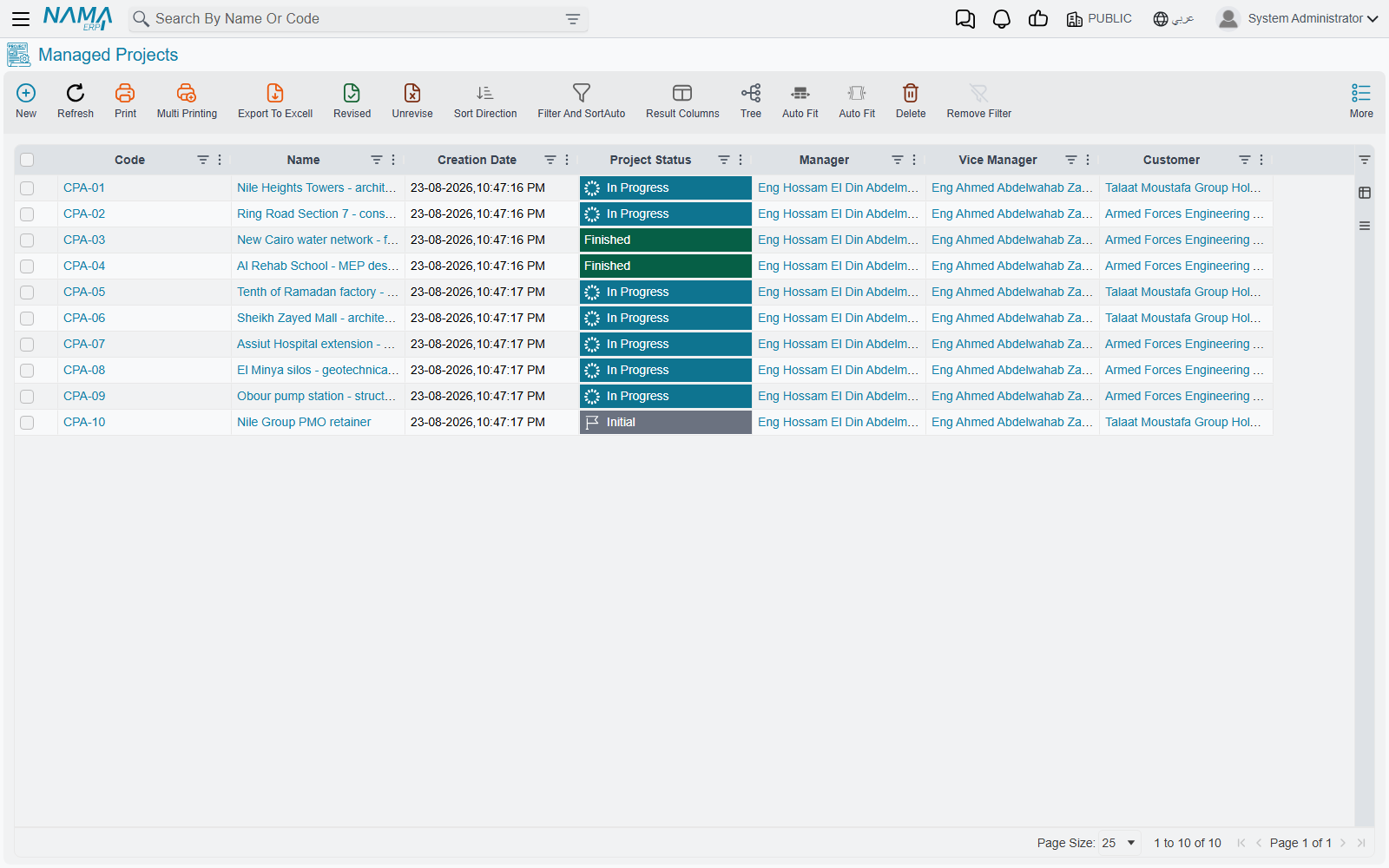

The Managed Project list view, showing status, manager and customer columns

The Module Is Called Project Management, Not ECPA

"ECPA" is the module's code, and you will meet it in licence dialogs and in support conversations. You will not meet it in the menu. The menu group is Project Management in English and ادارة المشاريع in Arabic, and a user hunting the tree for the letters E-C-P-A will not find them.

The same split runs one level down. Internally every record type in the module carries a CPA prefix, but on screen you see ordinary names — Managed Project, Task, Tasks Executing, Project Invoice. Use the screen names. The only place the internal prefix shows through is in the short codes on document books (CPAP, CPATS, CPAPI and so on), where it is harmless.

Two words that look identical in Arabic

Project Milestone (مرحلة) and Project Stage (مرحلة مشروع) are two completely different things, and their Arabic labels are one word apart.

A milestone is a master file — the name of a billable phase, such as "Schematic Design". You create a handful of them per project and hang tasks and invoice lines off them. A stage is a committed document — a schedule-and-money sheet with target dates, late-day counters and cost grids.

Never write or say a bare "مرحلة" when either could be meant. This documentation always qualifies.

Where the Name Came From

The short answer is that ECPA is not an abbreviation of anything the module does. It is the name of the firm it was built for.

ECPAs is a public accountants firm in Egypt, working in tax and audit. In 2014 they approached Namasoft wanting to manage their projects properly — the projects themselves, and the tasks needed to finish them. Out of that cooperation came this module.

So the module was named after them. CPA is for certified public accountants, which is also why every record type inside it carries a CPA prefix. With hindsight it should have been called Time Management or Project Management from the beginning — which is exactly what the menu says today. The code name simply stayed.

A note of thanks

Our thanks to Mr Ashraf Hagar, CEO of ECPAs, who trusted Namasoft with his firm's work back in 2014, when we had very little to show and almost no customers. That trust is why this module exists.

ECPAs are today one of Namasoft's strongest partners — they sell and implement Nama ERP themselves. It is a partnership that began with someone taking a chance on a young company.

Is This the Module You Want? Project Management vs Contracting

Nama has two modules that both say "project", and readers land here having picked the wrong one often enough that it is worth settling in one sentence:

Project Management is for firms whose product is billable professional hours. Contracting is for firms that build things — sub-contract work, measure quantities and issue payment certificates.

If the conversation involves a contractor, a bill of quantities, a purchase order, an executive budget or a site inspection, you are in Contracting, not here. The two modules share no records and no licence.

Project Management (ECPA)Contracting
What is soldPeople's time, priced by rate, plus fee milestonesWork quantities, priced per BOQ item and measured on site
The project recordManaged Project — a master file you edit in placeContract-centred documents
How cost is capturedHours on timesheets × a rate, plus expense documentsMaterial issues, direct costs, equipment allocation, daily labour
How the customer is billedProject Invoice, filled by sweeping timesheets and expense linesPayment certificates built from measured quantities
Sub-contractingNot modelled at allAn entire sub-system of contractors, their contracts and their certificates
BudgetsNot modelledEstimated and executive budgets, with execution documents
Purchasing, quality and site controlNot modelledPurchase requests and orders, inspections, test reports

There is one genuine name collision to be ready for. Contracting has a record type called simply Project; this module's is Managed Project (مشروع إداري). A customer licensed for both sees two unrelated "project" screens in the menu.

The Vocabulary You Set Up First

Before the first job is entered, a firm describes itself once. None of this is transaction data — it is the shared language every later screen filters and groups by.

Project Type and Project Sub Type classify the work — Residential, Commercial, and their sub-types. Type is the one classification that carries real behaviour: a task's type must belong to the same project type as its project, and several lookups cascade from it. Project Class is a reporting label and nothing more.

Disciplines (تخصص) are the professions in the firm — architectural, structural, electrical, mechanical. Milestones (مرحلة) are the phases a job is delivered and billed in — concept, schematic, detailed design, tender documents.

Those last two multiply together, and that multiplication is the heart of the module. A Phases Discipline Group stores a reusable set of (milestone, discipline) pairs, so a new project of a familiar shape inherits the whole grid in one action instead of being typed cell by cell. On the project itself the grid becomes a real matrix of work packages — four milestones × three disciplines is twelve packages, each with its own estimated hours and cost. This is covered end to end in Milestones and the Phase–Discipline Matrix.

Two more setup files complete the vocabulary: Task Types, which pin a task to a project type, and Project Expense Items, the catalogue of reimbursable categories — taxi, printing, courier, permit fee — each of which names the account its cost lands in.

From Quotation to Invoice

Here is the main line of work, in the order a job travels it.

  1. The quotation. A Project Sales Quotation prices the job: priced lines, the tasks the firm expects to perform with the hours and rates behind them, the expenses it expects to incur, and a payment schedule. It is a real document with a book and a term, but it books nothing to the ledger — it is a commercial offer.

  2. Winning the work. Accept Offer moves the quotation's status, and Create Project And Tasks turns it into a live Managed Project with its task list already populated. This is the module's real "new project" path.

  3. The project. The Managed Project is the spine of everything after that. It is a master file, not a document: it has no book, no term and no commit, and you keep editing it for the whole life of the job. Its state moves through a Change Project Status button; the project keeps no history of those moves. It holds the customer, the manager and vice-manager, the team, the milestone list, the discipline list and the work-package matrix.

  4. The tasks. Delivery is tracked as Tasks, also master files, each hanging off the project with a type, a milestone, a discipline and an executers grid — one row per employee, with that employee's planned hours, hourly rate and planned cost. The executers grid is where a project's labour estimate actually lives.

  5. The hours. Staff book their time on Tasks Executing (تنفيذ مهام), a daily document with Start and Stop buttons and one line per stretch of work. A separate Time Sheet Request screen records work someone intends to do. Hours booked on a timesheet land on the matching executer row as registered time.

  6. The approval. A manager raises a TimeSheet Approval, presses Collect Sheets to pull in the time waiting on projects they own, accepts or trims each line, and commits. That is the moment registered hours become actual hours, the task's cost total is rebuilt, and the project's own totals refresh.

  7. The out-of-pocket costs. A Project Expense Request is the employee's claim — a taxi, a printing bill — classified by expense item and tied to a task. A Project Expense Document is the accountant's side: press Collect Requests, commit, and the cost is booked and the claims are stamped as processed.

  8. The invoice. A Project Invoice bills the customer. Its distinguishing feature is the collect family of buttons, which sweep unbilled timesheet lines and unbilled expense lines into invoice lines so nobody re-types them. A Project Return gives money back on the same screen and the same kind of term — but on its own term record, which has to be configured as the mirror of the invoice's, because the return books in the same direction the invoice does.

Cutting across all of that, Procedures are free-form logged actions against a project or a task — a follow-up call, a submission to the municipality — either raised by hand or generated from timesheet lines.

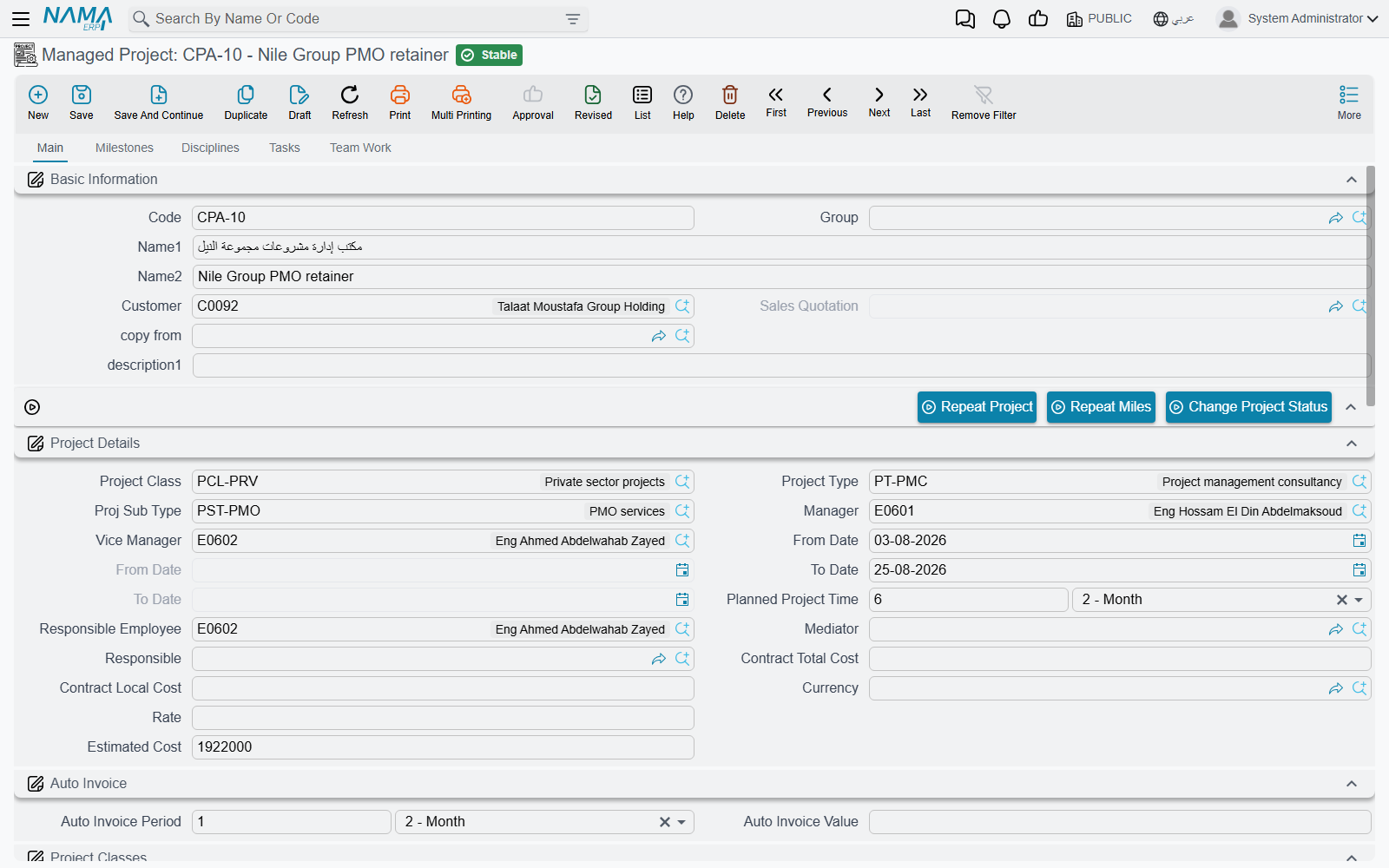

The Managed Project screen: identity, project details, the work-package matrix and the read-only status figures

The Schedule Track

Alongside the delivery line there is a second, looser track for schedule and money at the phase level.

A Project Stage is a committed document holding a set of milestone lines with a targeted period, an expected period, late-day and non-working-day counts — plus grids for the stage's incomes, its stock and supplier costs, its worker costs, its fixed-asset costs and its transportation costs. It is the only screen in the module that shows revenue and cost side by side.

A Project Stage Extension grants extra time on a stage, per milestone, against a two-level reason list.

One fact to carry from the start, because it shapes how the sheet is used: a project stage is not attached to a project. It has no project field. It reaches a project only through the milestones picked on its own lines, and it never writes anything back. Two projects' milestones can legally appear on one stage. This is explained where it matters, in Where Project Cost and Revenue Come From.

The Menu, Group by Group

Menu groupWhat you find there
Projects (مشاريع)Project Type, Project Sub Type, Managed Project, Project Class, Discipline, Phases Discipline Group, Project Milestone, Procedure, a shortcut to the shared Customer file, Template Project, Project Sales Quotation, Project Stage, Project Stage Extension, and the two stage-extension reason lists.
Tasks (المهام)Task Type and Task.
Task Execution / Approvals (تنفيذ / الموافقة على المهام)Tasks Executing, Time Sheet Request and TimeSheet Approval.
Expense (المصــاريف)Project Expense Item, Project Expense Request and Project Expense Document.
Invoice (الفاتورة)Project Invoice and Project Return.
Settings (الإعدادات)The module's single settings record — the rates and the standard monthly hours that turn recorded time into money. See Project Management Settings.

The Customer entry in the Projects group is a shortcut to the shared customer file used by the whole product, not an ECPA screen of its own.

Where the Module Is Thin

Three things are worth knowing before a firm commits to this module, because they shape what you can promise a customer.

Nothing enforces a budget. The quotation prices the job, the project screen carries a contract value and an estimated cost, and the matrix carries estimated hours and costs per work package. All of those are figures on a screen. No document blocks an over-run, no validation compares estimate to actual, and there is no budget record. Estimates in this module are informational.

The scheduling story is presentational. Project Stages and Stage Extensions record targeted and expected periods and count late days. That is the whole of it — there is no critical path, no dependency between tasks, no resource levelling and no Gantt chart. A firm that needs true schedule management runs it outside Nama and records the outcome here.

Reporting is two timesheet reports. The module ships Employee TimeSheet and Employee TimeSheet Details and nothing else — no project profitability report, no work-in-progress report, no dashboard. The Project Stage screen's income and cost grids are the nearest thing to a profitability view, and they are screen-only. See Project Management Reports for what the two reports do answer, and Where Project Cost and Revenue Come From for how to assemble the rest of the picture.

Where to Go Next

If you are setting the module up, read Project Types, Classes and Disciplines and then Milestones and the Phase–Discipline Matrix — the matrix is the concept everything else leans on.

If you are supporting a live site, start with The Managed Project and Where Project Cost and Revenue Come From. Between them they answer most of the questions that arrive.
