Contracting Configuration ​

The Contracting module keeps its settings in a single record, and that record shapes the behaviour of every contract, extract and cost document in the database. A handful of the switches on it change arithmetic rather than appearance — whether an extract prices this month's quantity or the cumulative quantity, whether term codes are typed or generated, which cost figure a subcontract inherits — so it is worth one careful read before the first live contract rather than a puzzled read afterwards. You open it from Administration → Settings → System Settings, where it is the Contracting Settings record.

There are around ninety options on the screen, and almost all of them arrive as one long alphabet soup in declaration order: one page, no tabs, and a single untitled block holding nearly every switch. Only two small titled groups follow it — Discount Calculation (the eight discount-percentage switches) and Tax Calculation Terms (the two tax terms) — and then three grids. That is why this page ignores the screen order entirely and groups the options by what they affect. If you are hunting for one option, use your browser's find rather than scrolling the screen.

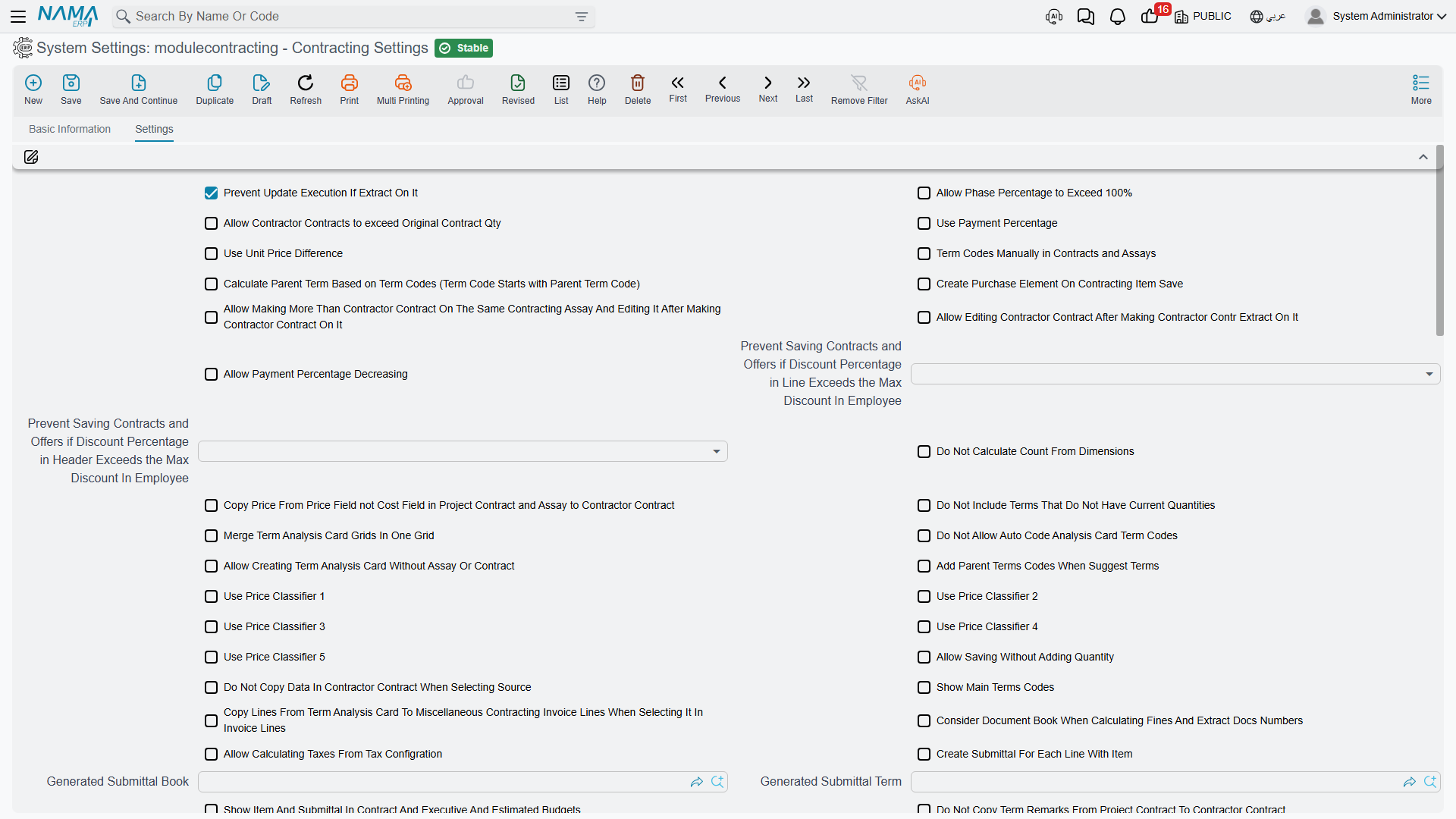

The Contracting settings — around ninety options on a single flat page

One Record for the Whole Database ​

Two facts about the record itself matter more than any individual option.

There is exactly one. Every piece of code that reads these settings reads the same single record, with no company or dimension passed in. So there is no per-company override: a group running three legal entities out of one database runs all three on the same contracting settings. If two companies need different term-coding rules or different extract pricing, that is not something this screen can give them.

It is read live. Nothing is cached into your contracts. Changing an option changes the behaviour of the next document you save, including documents that already existed — so a switch that changes how an extract prices its lines will change how an existing draft extract recalculates the moment you reopen and save it. Change these settings deliberately, and preferably not in the middle of a billing run.

Do not assume any option starts on. What is switched on depends on how the database was set up: the setup wizard's Contracting Configurations step saves only the options you tick there, and everything else stays off. Open this screen and check before relying on an option.

Term Codes and the Parent-Term Rule ​

A term code is the dotted outline number — 1, 1.1, 1.2, 2 — that identifies a line of work inside a contract and that every later document quotes when it bills, measures or costs that work. By default the system generates these codes for you from the position of the line in the grid. This group is about taking that away from it.

OptionWhat it changesWhen to turn it on
Term Codes Manually in Contracts and Assays
value.termCodesManual
Term codes on contracts and assays are typed by the user instead of generated from grid position.When the client's bill of quantities already has an official numbering that must be reproduced exactly — a government or consultant-issued BOQ, typically.
Manually Coded Terms Entities
value.manuallyCodedTermsEntities
A grid of document types. Anything listed here is manually coded; anything not listed is generated. If this grid has even one row it completely overrides the option above. Allowed types are the assay, both budgets, the project contract and the subcontract.When only some documents need manual codes — for example manual codes on the contract because the client dictates them, generated codes everywhere else.
Calculate Parent Term Based on Term Codes
value.calculateParentTermBasedOnTermCodes
The parent/child relationship in the term tree is derived from the code prefix, so 1.2.1 becomes a child of 1.2, rather than from the line's position in the grid. Requires manual term coding — the settings screen refuses to save this option without it.Whenever term codes are typed. With manual codes and this option off, the outline the user typed and the tree the system believes in can drift apart.
Do Not Allow Auto Code Analysis Card Term Codes
value.doNotAutoCodeAnalysisCardTermCodes
Suppresses the automatic analysis-term code on a term analysis card.Only if your cost analysts maintain their own analysis coding scheme.
Add Parent Terms Codes When Suggest Terms
value.addParentTermsCodesWhenSuggestTerms
Term-code suggestion offers parent (roll-up) codes as well as leaf codes.When users habitually bill or cost against header lines. Leave it off to force everyone onto leaf terms.
Consider Terms Project Remarks While Suggesting Term Code
value.considerTermProjRemarksWhileSuggestingTermCode
Term-code suggestion also matches on the project remarks typed against a term line, not just the code and description.When term descriptions are generic ("brickwork") and the useful distinguisher is in the remarks ("brickwork — block C stairwell").
Show Main Terms Codes
value.showMainTermCode
Header (roll-up) lines appear on extracts as well as leaf lines. Off by default.Only when the extract has to be printed with the client's full outline visible. Roll-up lines complicate the journal entry, so leave it off unless a client demands the layout.
Show Main Term Code In Executions
value.showMainTermCodeInExecutions
The same, for quantity execution documents.Same reasoning.

Phases ​

Phases are milestones inside a single term: "foundations 30%, structure 50%, finishes 20%". A term line carries exactly five phase slots — that is a hard ceiling, not a setting — and the percentages on them are expected to add up to 100%.

OptionWhat it changesWhen to turn it on
Allow Phase Percentage to Exceed 100%
value.allowPhasePercentageExceed100
Removes the check that a term's phase percentages sum to 100.For contracts where the phase percentages are indicative progress markers rather than a billing split. Leave it off if phases drive billing, because the check is the only thing catching a mistyped percentage.
Show Term Phase Lines
value.showPhaseTermLines
Adds the per-phase term grid to extracts, and — this is the important half — switches the extract's billing lines to be built from the phase lines rather than typed directly.When the client is billed per phase completed rather than per quantity executed. It changes how the extract is filled in, so decide it before the first extract, not during.

The phase master files themselves, and the five-slot ceiling, are covered in Phases and Work Areas.

What the Extract Calculates ​

These are the options that change the money. Most of them exist because different clients define "this month's value" differently.

OptionWhat it changesWhen to turn it on
Use Payment Percentage
value.usePaymentPercentage
Turns on the payment-percentage mechanism on extracts and shows its columns. Instead of billing the executed quantity outright, each term is billed at an agreed percentage of what is due.Contracts written as "we certify 90% of measured work now, the balance on completion".
Allow Payment Percentage Decreasing
value.allowPaymentPercentageDecreasing
Lets a later extract use a lower payment percentage than the previous one.Rarely. The default block exists because a falling percentage usually means a keying error. Turn it on only where genuine renegotiation downwards happens.
Calculate Prices Based On Total Quantity
value.calculatePricesBasedOnTotalQty
Line prices are computed from the cumulative quantity to date and the previous extracts are then netted off, rather than from this extract's quantity alone. Cannot be combined with the next option — the settings screen rejects both together.Cumulative-certificate contracts, where the certificate states total work to date and deducts previous payments. This is the classic international construction certificate shape.
Calculate Prices Difference From Previous Extract Only
value.calculatePricesDiffFromPreviousExtractOnly
Price differences are measured only against the immediately preceding extract instead of against everything billed before.When a client agrees revised rates from a given certificate onwards and does not want earlier certificates re-opened.
Use Unit Price Difference
value.useUnitPriceDifference
Enables the unit-price-difference mechanism on extracts, which carries a rate adjustment separately from the quantity being billed.When rates are revised mid-contract — an escalation clause, or an agreed variation to a rate — and the adjustment must be visible as its own figure rather than folded into the price.
Do Not Include Terms That Do Not Have Current Quantities
value.doNotIncludeTermsThatDoNotHaveCurrentQties
Collect Terms on an extract skips any term with nothing to bill this period.Almost always. On a 200-line bill of quantities it is the difference between an extract you can read and one padded with zero rows.
Copy Manual Total From Previous Quantity With From Document
value.copyManualTotalFromPreviousQtyWithFromDoc
When an extract is built "based on" an earlier document, the manually typed total is carried across too.Where the extract total is negotiated as a round figure and re-typing it every period is error-prone.
Subtract Remaining Tax Value With Percent From Due Value With Every Extract
value.subtractRemainingTaxValueWithPercentFromDueValueWithEveryExtract
With the "percentage of due value" payment method, the remaining tax portion is subtracted on every extract instead of being left to the end.When the tax on an advance or deduction must be relieved gradually alongside the recovery rather than in one lump.
Consider Document Book And Calculating Fines And Extract Docs Numbers
value.considerDocBookWhenCalcFinesAndExtractDocsNumbers
Extract and fine sequence numbers are counted per document book instead of globally.When each project or branch has its own book and each needs its own "extract no. 1".
Allow Creating Documents For Contracts That Have a Final Extract
value.allowUsingFinalizedContracts
Lets new documents be raised against a contract that has already been closed with a final extract.For genuine post-closure work — a snagging bill, a late-agreed variation — that the business does not want to handle as a new contract.

The Eight Discount-Percentage Switches ​

There are eight discount slots on an extract line, and for each one there is an option — Calculate discount 1 percentage from value through Calculate discount 8 percentage from value (value.calcDisc1PercentFromValue … value.calcDisc8PercentFromValue) — that reverses the direction of the calculation. Off, you type a percentage and the system computes the amount. On, you type the amount you actually negotiated and the system derives the percentage.

Turn on the slots your business negotiates as flat amounts and leave the rest off. It is worth knowing that this is resolved in a three-level cascade: the module setting is the default, the contract can override it, and the extract's document term can override that. So this screen sets house style, not law.

Quantity Executions ​

OptionWhat it changesWhen to turn it on
Prevent Update Execution If Extract On It
value.preventUpdateExeDocIfExtract
Blocks editing an execution document once an extract has consumed it.Turn it on. Editing a measurement that has already been billed is how billed quantities and measured quantities silently diverge.
Allow Current Quantity Percentage Exceed Permitted Percentage
value.allowCurrentQuantityPercentageExceedPermittedPercentage
Lets the current-quantity percentage on an execution go past the permitted percentage set on the contract's term line.Where the permitted percentage is guidance rather than a contractual cap.

When a Contract, Assay or Subcontract Can Still Be Edited ​

The module locks documents once downstream money exists. These options unlock them again, and each one is a deliberate trade of safety for flexibility.

OptionWhat it changesWhen to turn it on
Allow Edit Prices And Quantities In Project Contract After Make Extracts
value.allowEditPricesAndQtysInProjContractAfterMakeExtracts
Unlocks prices and quantities on a project contract that already has extracts.Only where the alternative — a contract update document — is genuinely impractical. The update document exists precisely so that this option is not needed; see Project Contract Updates.
Allow Editing Contractor Contract After Making Contractor Contr Extract On It
value.allowEditingContrContractAfterMakingContrExtract
The same, for a subcontract that has been extracted against.Same reasoning.
Allow Making More Than Contractor Contract On The Same Contracting Assay And Editing It After Making Contractor Contract On It
value.allowEditingAndMoreThanContrContractOnSameAssay
Lets several subcontracts be created from one assay, and lets the assay be edited afterwards.When one priced bill of quantities is split between several subcontractors — a common arrangement when trades are let separately.
Allow Saving Without Adding Quantity
value.allowSavingWithoutAddingQuantity
Lets a contract term line be saved with an empty quantity.For provisional or rate-only items whose quantity is genuinely unknown at signature.
Project Term Code Can Be Empty In Contractor Contracts
value.projTermCodeCanBeEmptyInContractorContracts
Makes the link from a subcontract line back to a project-contract term optional.Rarely, and with care: that link is what attaches the subcontractor's cost to the project term. Leaving it empty means the cost lands nowhere.
Allow Contractor Contracts to exceed Original Contract Qty
value.allowSubcontractsExtraQties
Lets the total quantity subcontracted for a term exceed the quantity contracted with the owner.When subcontractors are deliberately over-let — wastage allowances, or overlapping scopes that will be reconciled later.
Calculate Price From Profit Percent With Commit
value.calcPriceFromProfitPercentWithCommit
Recomputes the term price from cost plus the profit margin on every save.When pricing is genuinely formula-driven. Leave it off if negotiated prices must survive a re-save.
Copy Price From Price Field not Cost Field in Project Contract and Assay to Contractor Contract
value.copyPriceFromContractAndAssayToContrContract
When a contract or assay is converted into a subcontract, the subcontract inherits the price rather than the cost figure.When you sublet at your selling rate rather than at your internal cost — for instance where the subcontractor takes the whole scope at the contracted rate. Off, the subcontract starts from your cost estimate.
Do Not Copy Data In Contractor Contract When Selecting Source
value.doNotCopyDataInContractorContractWhenSelectingSource
Picking a source document on a subcontract stops copying that document's data across.When subcontracts are built by hand and the copy is more nuisance than help.
Do Not Copy Term Remarks From Project Contract To Contractor Contract
value.doNotCopyTermRemarksFromProjectContract
Suppresses copying term remarks into a subcontract.When the owner-facing remarks are commercially sensitive or simply irrelevant to the trade contractor.

Discount Ceilings from the Employee File ​

Two options — Prevent Saving Contracts and Offers if Discount Percentage in Line Exceeds the Max Discount In Employee (value.maxDiscPercenForEmpToApplyOnContracting) and the matching … in Header … (value.maxDiscPercenForEmpToApplyOnContractingHeader) — enforce the maximum discount recorded on the employee's own file against contracts and offers. One covers discounts typed on a line, the other the discount on the document header. Each is a choice of how strictly to enforce, so set the one that matters and leave the other alone if header discounts are not used. Turn them on when sales staff have individual discount authority that has to hold.

Cost Attribution and the Analysis Card ​

A term analysis card breaks one term's cost into the materials, workers, subcontractors and expenses that deliver it. These options change how the card behaves and where its numbers travel.

OptionWhat it changesWhen to turn it on
Merge Term Analysis Card Grids In One Grid
value.mergeTermAnalysisCardGrids
The card's four cost grids — materials, workers, subcontractors, other expenses — collapse into one grid.When analysts prefer one list they can sort and filter over four tabs. It changes the screen layout, so agree it once rather than toggling it.
Allow Creating Term Analysis Card Without Assay Or Contract
value.allowCreatingAnalysisCardWithoutAssayOrContract
Lets a card be saved with no source assay or contract.When cost analysis is done as library work — standard recipes built in advance — rather than always against a live job.
Analysis Card Cost Copied Field To From Doc
value.analysisCardCostCopiedFieldToFromDoc
Names which of the card's cost fields is pushed back onto the document the card was built from.Where the card computes several cost variants and only one of them is the number the contract should carry.
Do Not Copy Data In Analysis Card When From Doc Is Contracting Offer
value.doNotCopyDataInAnalysisCardWhenFromDocIsContractingOffer
An analysis card built from a contracting offer does not copy that offer's data.When cards built from offers are meant to start clean because the offer's figures were commercial, not analytical.
Calculate Estate Cost From Term Analysis Card
value.calculateEstateCostFromTermAnalysisCard
Actual cost pushed onto Real Estate units is taken from the analysis card instead of from the contract's term lines.Developer-contractors who cost their own units and keep the detailed recipe on the card. See Pushing Cost onto Real Estate Units.
Copy Lines From Term Analysis Card To Miscellaneous Contracting Invoice Lines When Selecting It In Invoice Lines
value.copyLinesFromTermAnalysisCardToInvoiceLines
Picking an analysis card inside a miscellaneous contracting invoice line copies the card's lines into the invoice.When sundry purchases mirror an analysis recipe and re-typing them is wasted work.
Show Only Analysis Card Terms With Items
value.showOnlyAnalysisCardTermsWithItems
On a miscellaneous contracting invoice, only analysis-card terms that carry an inventory item are offered.When those invoices are only ever used for item-based spend, so the list is not cluttered with labour and expense lines.

The card itself, and how its analysed cost becomes a unit cost and then a selling price, is in Term Analysis Cards.

Material Issue and Purchasing Rules ​

OptionWhat it changesWhen to turn it on
Show Items In Analysis Card Only
value.showItemsInAnalysisCardOnly
On a contracting material issue, the item lookup is restricted to items that appear on the analysis card.When the analysis card is treated as the authorised material list for the term — the closest thing the module has to a material budget on issue.
Create Purchase Element On Contracting Item Save
value.createPurchaseElementOnContractingItemSave
Saving a direct-cost item automatically creates its purchasing element.When cost items are routinely bought, so the purchasing side does not have to be set up twice.
Do Not Copy Data In Contractor Purchase Order And Request When Selecting Contract
value.doNotCopyContractDataInPurchaseDocs
Picking the project contract on a contracting purchase request or order no longer copies the project and the contract's term lines into the document.When purchase lines never mirror the contract's bill of quantities and deleting the copied lines is more work than typing the few you need. See Contracting Purchase Requests and Orders.
Update Tax Reg No And Commercial Reg No With Save In Contracting Misc Invoices
value.updateTaxRegNoAndCommercialRegNoWithSaveInContractingMiscInvoices
Refreshes the supplier's tax-registration and commercial-registration numbers on a miscellaneous contracting invoice each time it is saved.Where those numbers appear on printed or e-invoiced documents and must reflect the supplier file as it stands today.

The two material streams themselves behave very differently — project issues carry no money, subcontractor issues are invoices — and that distinction is covered in Issuing Material to a Project and Selling Material to a Subcontractor.

Price Lookup and Measuring ​

OptionWhat it changesWhen to turn it on
Use Price Classifier 1 … Use Price Classifier 5
value.usePriceClassifier1 … value.usePriceClassifier5
Each switch reveals one more classifier column on contracting price lists and adds it to the price lookup, so a rate can be qualified by up to five extra attributes.Turn on only as many as you actually price by. Every classifier you enable is another column that must be matched for a price to be found.
Do Not Calculate Count From Dimensions
value.doNotCalcCountFromDimensions
Stops the term sheet's count being derived from the length, width and height entered on the line.When quantities are surveyed and typed directly, and the dimension fields are descriptive only.

How a rate is resolved when several price lists overlap is explained in Contracting Price Lists.

Showing the Measurement Behind a Quantity ​

One option — Add Dimensions Fields To Contracts And Extracts And Executions (value.addDimensionsFieldsToContractsAndExtractsAndExecutions) — adds the length, width and height columns to those three document families, so a quantity can be shown as the measurement it was derived from rather than as a bare number. Turn it on when quantity surveyors work from measured dimensions and want the working shown on the document; leave it off to keep the grids narrow.

Budgets and Customer Submittals ​

OptionWhat it changesWhen to turn it on
Show Item And Submittal In Contract And Executive And Estimated Budgets
value.showInvItemAndSubmittalInContracts
Adds the inventory-item and customer-submittal columns to contracts and to both budgets.When material approval matters commercially — that is, when the client approves specific products before they may be bought.
Create Submittal For Each Line With Item
value.createSubmittalForExecutiveBudgetLines
A customer submittal is created automatically for every executive-budget line that carries an item.When every specified material must go to the client for approval as a matter of course. Off, submittals are raised by hand.
Generated Submittal Term
value.generatedSubmittalTerm
The document term stamped on those auto-created submittals.Fill it whenever the option above is on, or the generated submittals arrive with no term.
Generated Submittal Book
value.generatedSubmittalBook
The document book stamped on them, which also supplies their numbering.Same — fill it together with the term.
Update Term Quantity From Contractors Extract In Budget
value.updateTermQuantityFromContractorsExtractInBudget
Subcontractor extracts write their certified quantity back onto the budget's term line.When the budget is used to track progress as well as money, and the subcontractors are doing the work being tracked.

What the budget does and does not prevent is answered squarely in Budget Item Requests.

Tax Setup Shortcuts ​

OptionWhat it changesWhen to turn it on
Allow Calculating Taxes From Tax Configuration
value.allowCalculatingTaxesFromTaxConfiguration
Extract and budget-execution lines may take their tax from the central tax configuration instead of only from the term.Turn it on unless taxes are deliberately maintained per standard term and must never be sourced elsewhere.
Project Contract Term To Calculate Tax
value.projectContractTermToCalculateTax
Names the document term whose tax setup an assay borrows when it computes tax for a project contract.Fill it if assays are used and their tax figures must match what the eventual extract will charge.
Contractor Contract Term To Calculate Tax
value.contractorContrTermToCalculateTax
The same, for a subcontract.Same.
Calculate Conditions Percentage From Contract Total Before Taxes
value.calcConditionsPercentFromTotalBeforeTaxes
A Percentage From Total condition that is not tied to one term code is computed on the sum of the term lines' prices before taxes instead of on the contract total.When a retention or advance clause is agreed as a percentage of the contract value excluding VAT. See Contract Conditions.

Tax on extracts is a bigger subject than these switches — the tax extract terms and the missing-term strategy are covered in Taxes on Extracts.

Real-Estate Cost Distribution ​

For developer-contractors who build what they sell, construction cost can be pushed onto individual Real Estate units.

OptionWhat it changesWhen to turn it on
Calculate Estate Estimated Cost With
value.calculateEstateCostFrom
Names the one document type whose commit feeds estimated cost onto the units: the project contract, the subcontract, or one of the two budgets.Pick the document your business treats as the cost plan of record. Leaving it empty means no estimated cost is pushed.
Calculate Estate Estimated Cost Based On
value.estateEstimatedCostBasedOn
The basis on which a cost is spread across the units — unit area, for example. This one setting governs both the estimated and the actual distribution passes.Set it to whatever your cost-sharing convention is. Empty falls back to unit area.
Calculate Estate Cost From Term Analysis Card
value.calculateEstateCostFromTermAnalysisCard
Takes actual cost from the analysis card instead of from contract terms.As described under the analysis card above.

The bridge itself is described in Pushing Cost onto Real Estate Units.

Employees, Equipment and Labour Cost ​

Stationing a person or a machine on a project is an allocation document; turning that allocation into money is a separate cost document. These options tune both.

OptionWhat it changesWhen to turn it on
Term Code Required In Employee Equipment Allocation
value.termCodeRequiredInEmployeeEquipmentAllocation
Makes the term code mandatory when allocating a person or machine to a project.When allocation cost must always land on a specific term rather than on the project generally. Recommended, since a cost line with no term code contributes nothing.
Allow Date Overlapping In Employee And Equipments Project Allocation
value.allowOverlappingInContrEmployeeEquipmentAlloc
Lets one person or asset be allocated to overlapping date ranges.When people and plant genuinely split their time across projects in the same week. Off, the system treats an overlap as a mistake.
Cost Salary Components
value.costSalaryComponents
A grid naming which payroll components flow into contracting labour cost. Each row picks a component and, for components whose effect type is "Other", also the effect it should be treated as.Fill it before the first cost distribution. Only listed components reach project cost — an empty grid means salaries never become project cost.
Copy Last Project To Employee In Field / … To Asset In Field / … To Car In Field
value.copyLastProjectToEmployeeInField / value.copyLastProjectToAssetInField / value.copyLastProjectToCarInField
Each names a field on the employee, asset or vehicle master file that receives the most recent project the resource was allocated to.When supervisors need to see current deployment on the resource's own file rather than by searching allocations.
Copy Last Branch To Employee In Field / … To Asset In Field / … To Car In Field
value.copyLastBranchToEmployeeInField / value.copyLastBranchToAssetInField / value.copyLastBranchToCarInField
The same three, for the branch instead of the project.Same, where branch matters for reporting or authorisation.

The salary-components grid is validated line by line: a component whose effect type is "Other" must say which effect to treat it as, and a component of any other type must leave that column empty. Get it wrong and the settings screen names the offending row.

The documents themselves are in Employees, Equipment and Their Costs, and the labour side in Daily Labour and Site Diary.

Cheques on Payment Schedules ​

One grid on this screen (value.docs) controls which contracts can mint financial papers — cheques — from their payment schedule. Listing the project contract, the subcontract, or both, makes the cheque-creation columns appear on that contract's payment-schedule grid; leave the grid empty and no contract can generate cheques. Its label says only Documents, which does not hint at what it does, so it is easy to miss.

Fill it when the business hands over post-dated cheques against an instalment plan at signature — a common arrangement on subcontracts.

What Blocks Saving the Settings Screen ​

Three rules are checked when you save, and each produces a message that names the fields involved:

  1. Calculate Parent Term Based on Term Codes without manual term coding. The parent-from-code rule only makes sense when the codes are typed, so the screen refuses the combination.
  2. Calculate Prices Based On Total Quantity together with Calculate Prices Difference From Previous Extract Only. These are two different definitions of the same thing and cannot both be true.
  3. An inconsistent salary-component row, as described above.

If a save is refused, the message points at the option pair or the row index — fix that and save again.
